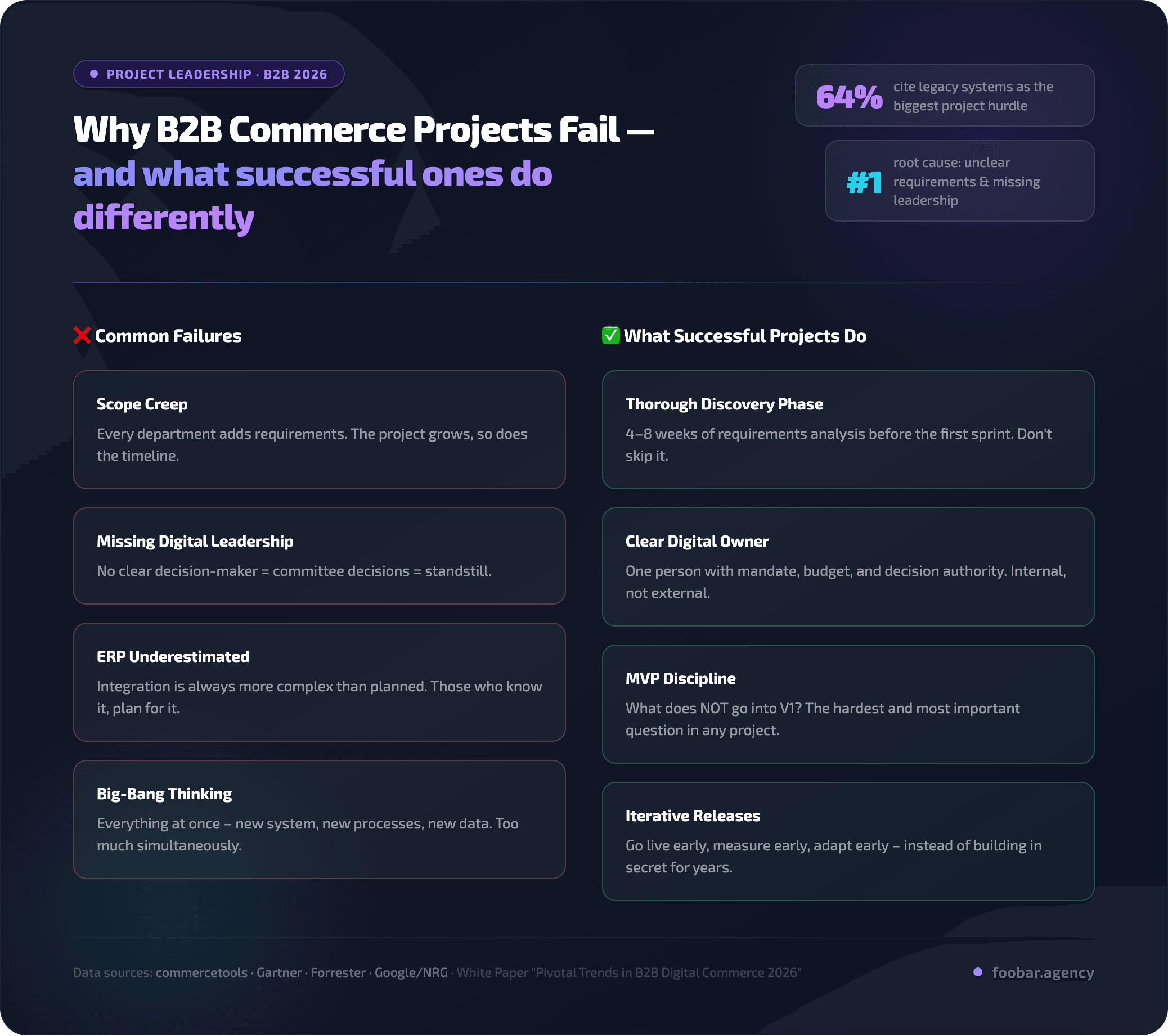

Why B2B eCommerce Projects Fail – and What the Successful Ones Do Differently
The numbers are striking—and sobering. According to commercetools data, 64 percent of B2B eCommerce projects in the DACH region fail or stall before reaching their goals. The culprit: not technology. The blame lies in unclear requirements, missing digital leadership, and a planning approach that systematically underestimates the complexity of ERP integration and stakeholder management. The good news: Projects that actually work do one thing differently from the start.
Four Mistakes That Lead to Failure
1. Scope Creep – The Requirements List Becomes Impossible
It starts innocently. The CFO has a question. The supply chain manager needs another feature. The marketing director wants an integration enhancement. Each request is individually rational. Together they create a project that can't be managed anymore.
At a large B2B company we advised, a commerce project started with 120 requirements. After three months: 280. After six months the project was stopped because complexity was unmanageable. The budget was halved, the scope had tripled, and nobody could say when it would be finished anymore.
The problem: Without clear prioritization and without someone authorized to say no, every feature becomes a "must-have." And a hundred must-haves is not executable.
2. Missing Digital Leadership – Decisions Take Months Instead of Days
Most B2B companies have a massive stakeholder problem. Marketing wants one thing, sales another, operations a third. And the decision doesn't fall with the project manager—it falls in a committee that meets once a month.
A relaunch project at a machinery manufacturer showed the classic pattern: An architect proposed a solution. It went for approval to the CIO. The CIO coordinated with the CFO. The CFO wanted further analysis. That analysis took eight weeks. The proposed solution was obsolete by then. Another topic demanded attention. The project moved further back.
Successful projects have one clear owner—not (only) a governance structure. One person with genuine decision-making authority. That person can say no to a feature in three hours; not three months.
3. ERP Integration Is Systematically Underestimated
The biggest challenge in B2B eCommerce isn't the frontend. It's not the design. It's ERP integration—and it's underestimated in almost every project.
A distributor we worked with said: "Our SAP is 25 years old. Nobody documents which data flows where. And ERP integration has to be perfect because operations falls apart otherwise." The planned integration was mentioned in two lines in the requirements list. Only during analysis did it become clear: The project needed two additional months just for integration engineering.
According to the commercetools whitepaper, ERP/CRM integration is the number-one hurdle in B2B eCommerce implementations. And it's budgeted optimistically in nearly every project.
4. Big-Bang Thinking – The Attempt to Change Everything at Once
The classic mistake: "We'll switch everything over at once. New technology, new processes, new data structure, new team—all in parallel." That's not ambitious. That's reckless.
A major retailer tried exactly that: new eCommerce system, new fulfillment structure, newly organized IT team, new performance metrics. The launch was a disaster. Because processes didn't work, because the team wasn't trained, because nobody knew who was responsible for problems.
Successful projects change one thing at a time. They launch early with reduced scope, measure, learn, and then build further.
What Successful Projects Do Differently From Day One
Discovery Before Delivery – 4 to 8 Weeks of Intensive Analysis
The most successful B2B eCommerce projects don't start with development. They start with discovery. Four to eight weeks answering these questions:
- What are the business-critical use cases for phase one?
- What does the system landscape look like? (ERP, CRM, PIM, warehouse—who's connected to whom?)
- Who are the internal stakeholders and what do they really need?
- How realistic is the planned ERP integration? (Not: What does the CFO hope? But: What does the ERP admin say?)
This intensive discovery phase costs time and budget. It saves millions by avoiding surprises.
MVP Discipline – The Hardest Question: What Does NOT Go in V1?
Successful projects follow a radical discipline: They don't define what goes in. They define what stays out.
A chemical trader rebuilding its portal started with 200 requirements. After discovery: 45 requirements for V1. That was the hardest part—not the execution, but deciding which 155 features go into phase two.
The result: The MVP launches faster, has fewer bugs, and delivers real feedback quickly.
Digital Owner With Real Authority – Decisions, Not Committees
Successful projects have one person who owns accountability. They can say "yes, that goes in" or "no, it doesn't"—and it's binding. This person isn't in a committee. They're in the project.
Iterative Releases – Launch Early, Learn Early
Instead of 18 months in development then bang at launch: MVP live after 3–4 months. Measure. Phase 2 after another 2–3 months. Phase 3 later. This reduces risk and increases learning.
What This Means for Your Project Planning
1. Realistic Timeframe
- Discovery: 4–8 weeks depending on system complexity
- MVP: 3–6 months depending on ERP landscape and scope
- Phase 2 & 3: Iteratively, based on real feedback
Anyone planning less than 4 weeks of discovery is planning for more problems.
2. Budget as Investment, Not One-Time Spend
- V1: Base investment
- V2 + V3: Iteration budget
- Whoever funds only V1 funds half a transformation.
3. Internal Resources That Are Actually Needed
- One product owner (internal, not external)
- IT interface to the ERP team
- Subject matter representatives for requirements
- One decision-maker for escalations
That's not a big team. But it's a focused team.
Choosing the Right Agency
A good B2B eCommerce agency:
- Knows the reality of ERP integrations (SAP, Dynamics, NetSuite—not just theory, but real complexity)
- Can have clear scope conversations and say no when needed
- Has seen failing projects and uses that knowledge to save future ones
- Doesn't promise 90 days for everything—but 4 weeks discovery, then an honest timeline
Checklist: Is Your Organization Ready?
Before you start, check these points:
- Do you have clear business goals for phase one? (Not: "Make everything new," but: "Cut order time by 40 percent.")
- Is there a recognized business owner? (CEO, sales leader, or CDO—with decision-making authority.)
- Are your system landscapes documented? (ERP, CRM, warehouse, accounting—a rough overview.)
- Can you launch phase one in 4–6 months—and actually go live? (Or will you get impatient later?)
- Can you assign 3–5 people internally? (Projects without internal engagement fail.)
If you answer yes to four of these: You're ready.
